Case study on delay in public housing projects: the junction of ase study on delay in public housing projects: the junction of
C
S
Sung Wong Toi Road and To Kwa Wan Road, Ma Tau Kokung Wong Toi Road and To Kwa Wan Road, Ma Tau Kok

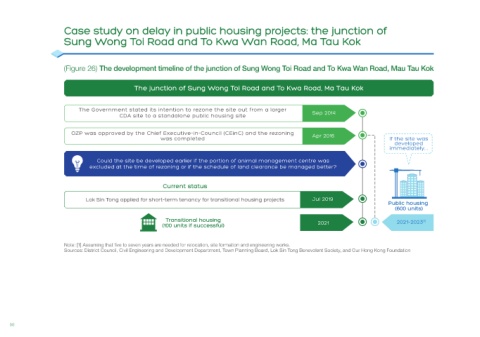

(Figure 26) The development timeline of the junction of Sung Wong Toi Road and To Kwa Wan Road, Mau Tau Kok
The junction of Sung Wong Toi Road and To Kwa Road, Ma Tau Kok
The Government stated its intention to rezone the site out from a larger
CDA site to a standalone public housing site Sep 2014
OZP was approved by the Chief Executive-in-Council (CEinC) and the rezoning Apr 2016
was completed If the site was
developed
immediately...
Could the site be developed earlier if the portion of animal management centre was
excluded at the time of rezoning or if the schedule of land clearance be managed better?
Current status
Lok Sin Tong applied for short-term tenancy for transitional housing projects Jul 2019
Public housing
(600 units)
Transitional housing 2021–2023 [1]
(100 units if successful) 2021
Note: [1] Assuming that five to seven years are needed for relocation, site formation and engineering works.
Sources: District Council, Civil Engineering and Development Department, Town Planning Board, Lok Sin Tong Benevolent Society, and Our Hong Kong Foundation
