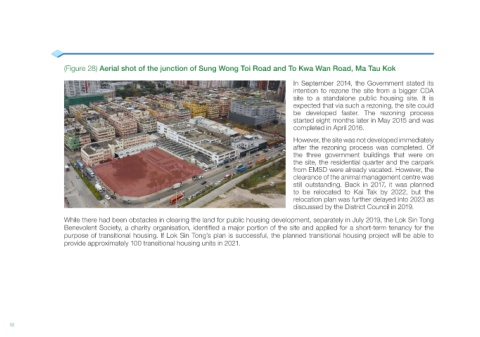

(Figure 28) Aerial shot of the junction of Sung Wong Toi Road and To Kwa Wan Road, Ma Tau Kok

                                                                                        In September 2014, the Government stated its
                                                                                        intention to rezone the site from a bigger CDA
                                                                                        site to a standalone public housing site. It is
                                                                                        expected that via such a rezoning, the site could
                                                                                        be developed  faster. The  rezoning process
                                                                                        started eight months later in May 2015 and was
                                                                                        completed in April 2016.
                                                                                        However, the site was not developed immediately
                                                                                        after the rezoning process was completed. Of
                                                                                        the three government buildings that were on
                                                                                        the site, the residential quarter and the carpark
                                                                                        from EMSD were already vacated. However, the
                                                                                        clearance of the animal management centre was
                                                                                        still outstanding. Back in 2017, it was planned
                                                                                        to be relocated to Kai Tak by 2022, but the
                                                                                        relocation plan was further delayed into 2023 as
                                                                                        discussed by the District Council in 2019.
                    While there had been obstacles in clearing the land for public housing development, separately in July 2019, the Lok Sin Tong
                    Benevolent Society, a charity organisation, identified a major portion of the site and applied for a short-term tenancy for the
                    purpose of transitional housing. If Lok Sin Tong’s plan is successful, the planned transitional housing project will be able to
                    provide approximately 100 transitional housing units in 2021.
