Page 56 - LH_Research_Report_2020_Eng
P. 56
Case study on delay in public housing projects: ase study on delay in public housing projects:
C
Area 48, Fanling/Sheung Shuirea 48, Fanling/Sheung Shui
A

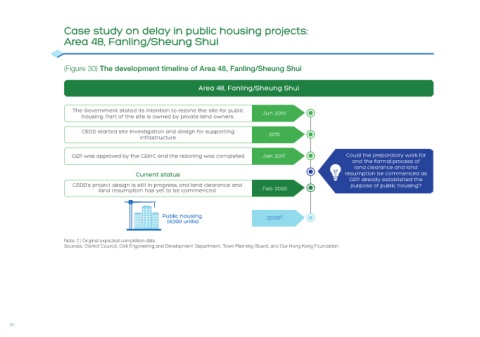

(Figure 30) The development timeline of Area 48, Fanling/Sheung Shui
Area 48, Fanling/Sheung Shui
The Government stated its intention to rezone the site for public Jun 2014
housing. Part of the site is owned by private land owners.
CEDD started site investigation and design for supporting 2015
infrastructure
OZP was approved by the CEinC and the rezoning was completed Jan 2017 Could the preparatory work for
and the formal process of
land clearance and land
Current status resumption be commenced as
OZP already established the
CEDD’s project design is still in progress, and land clearance and purpose of public housing?
land resumption has yet to be commenced Feb 2020
Public housing 2028 [1]
(4,000 units)
Note: [1] Original expected completion date.
Sources: District Council, Civil Engineering and Development Department, Town Planning Board, and Our Hong Kong Foundation
