Case study on delay in public housing projects: ase study on delay in public housing projects:
C
Pik Wan Road Sites A & B, Yau Tongik Wan Road Sites A & B, Yau Tong
P

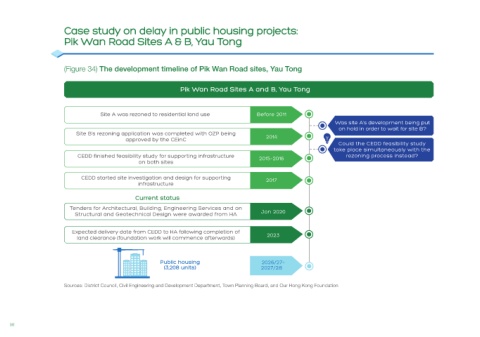

(Figure 34) The development timeline of Pik Wan Road sites, Yau Tong
Pik Wan Road Sites A and B, Yau Tong
Site A was rezoned to residential land use Before 2011
Was site A’s development being put
on hold in order to wait for site B?
Site B’s rezoning application was completed with OZP being
approved by the CEinC 2014
Could the CEDD feasibility study
take place simultaneously with the
CEDD finished feasibility study for supporting infrastructure 2015–2016 rezoning process instead?
on both sites
CEDD started site investigation and design for supporting 2017
infrastructure
Current status
Tenders for Architectural, Building, Engineering Services and on
Structural and Geotechnical Design were awarded from HA Jan 2020
Expected delivery date from CEDD to HA following completion of
land clearance (foundation work will commence afterwards) 2023
Public housing 2026/27–
(3,208 units) 2027/28
Sources: District Council, Civil Engineering and Development Department, Town Planning Board, and Our Hong Kong Foundation
